Variations in a construction project don’t always mean higher costs. Sometimes, they reduce the contract value. This is what we call negative variation. But does cutting costs always benefit a project, or can it create bigger challenges down the line?
Let’s talk about what negative variations are, why they happen, and how they impact contracts and project finances. We’ll also explore strategies to manage them effectively to help you avoid disputes and keep projects on track.
What is a Negative Variation?
A negative variation, also known as an omission or deletion, is a change in a construction project that reduces the scope of work and lowers the contract value. This can happen due to the elimination of certain features, changes in project specifications, or cost-cutting measures.
Unlike positive variations, which add work and increase costs, negative variations do the opposite. They scale back or remove work to reduce expenses.
While negative variations can help control expenses, they also impact contractor agreements, cash flow, and project timelines, requiring careful management.
If you want a deep dive into variations and their role in project success, check out our guide on Variation in Construction.

Why Do Negative Variations Happen?
Negative variations happen for a simple reason: plans change. Whether it’s a budget cut, a design tweak, or a regulatory shift, these changes reduce the contract value by removing or scaling back work.
Here are the common causes of variation in construction project:
- Design Changes: Project designs often evolve throughout the construction process. As the project progresses, stakeholders may reassess certain elements. This reassessment is based on practical considerations or changing requirements.
- Scope Reduction: Financial constraints or shifting priorities can necessitate a reduction in project scope. This often involves scaling back or eliminating certain project elements. Such changes aim to align with budget limitations or revised objectives.
- Material Substitutions: Substituting more cost-effective materials for originally specified higher-end options is common. It's a strategy to manage project costs.
- Regulatory Changes: Building codes, safety standards, or environmental regulations can change. These changes may necessitate modifications to project plans. Sometimes, this results in the elimination of previously planned elements.
- Errors in Project Estimation: As projects progress, more precise information becomes available. This can lead to revisions of initial estimates. Sometimes, these revisions result in reductions to the original scope.
How Negative Variations Impact Construction Contracts
Not all construction contracts handle variations the same way. The terms of the contract determine how a negative variation is processed and who benefits from the cost reduction.
Here’s how negative variations affect different contract structures:
Negative Variations in Lump Sum Contracts

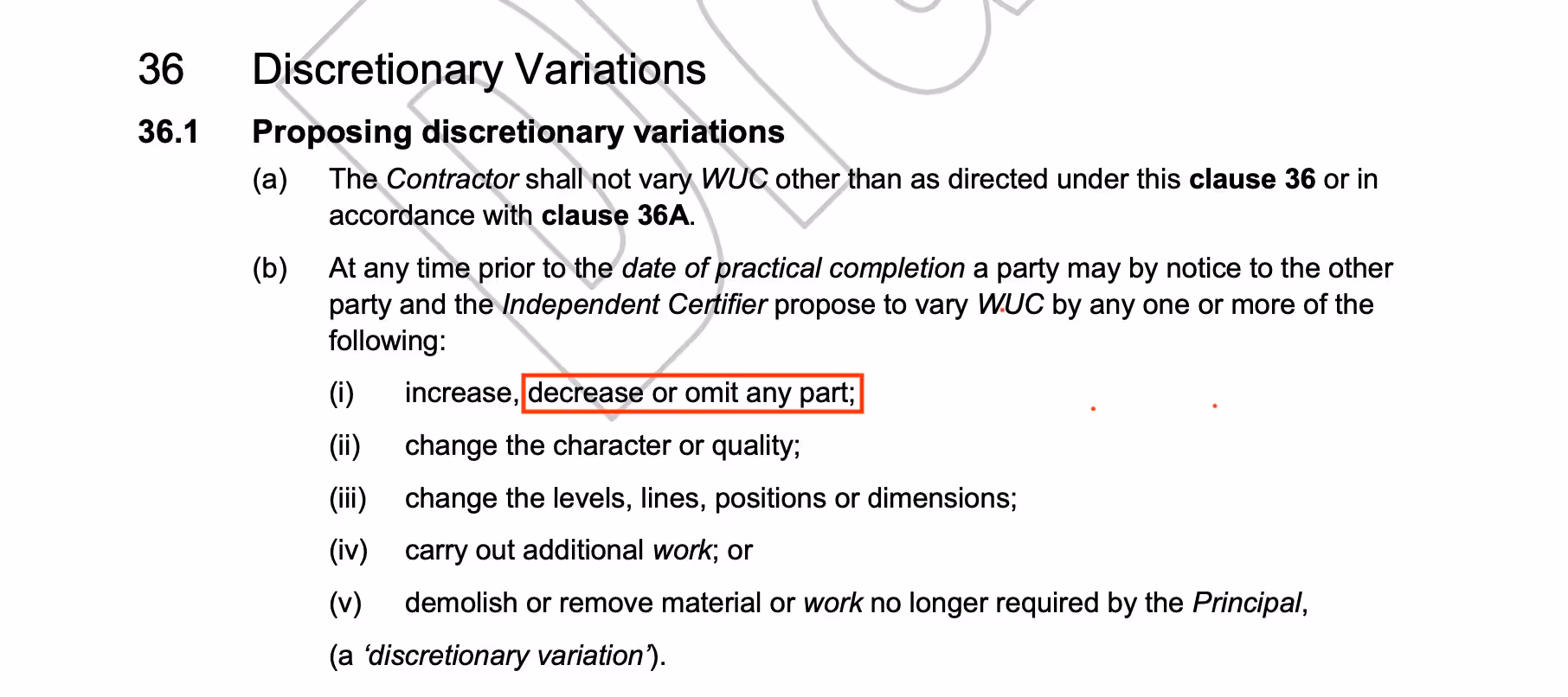

In a lump sum contract, the project price is fixed. If a negative variation occurs, the contractor must adjust their work and accept a lower payment. However, lump sum contracts often include variation clauses that outline how price reductions are calculated.
The challenge? Contractors may have already committed to buying materials or hiring subcontractors, making sudden reductions problematic.
💡Example: If a project originally included 100 custom-made windows and the owner decides to install only 50, the per-unit cost for manufacturing and installation might rise. Contractors may push back on reductions that don’t fairly account for fixed costs like equipment rentals, site overheads, or labor commitments. Without clear variation clauses, these adjustments can lead to disputes over how much should be deducted.
Negative Variations in Cost-Plus Contracts
Cost-plus contracts reimburse contractors for actual costs plus a management fee. When a negative variation removes work, the total project cost decreases. This means the contractor gets reimbursed for less.
This can impact the contractor’s earnings, especially if their fee is percentage-based. A smaller project means a smaller profit. This is why some contractors negotiate a minimum fee to protect their margins.
For instance, if a contractor’s fee is 10% of project costs and a $500,000 work reduction occurs, they lose $50,000 in profit. This can make contractors less willing to accept negative variations without compensation discussions.
Negative Variation in Unit Price Contracts
Unit price contracts break the project into measurable components (e.g., per square meter of concrete). If a negative variation removes certain work items, the total contract value decreases.
This approach makes processing variations straightforward, but if a large portion of the work is removed, the contractor might struggle to cover overhead costs. Some contracts include minimum payment protections to ensure contractors aren’t unfairly impacted by major reductions.
Negative Variations in Design and Construct Contracts
In design and construct contracts, the contractor is responsible for both the design and construction phases. Negative variations can be more complex in these contracts because scope reductions may affect design fees, material procurement, and construction methods.
💡 Example: If an office tower project initially included a rooftop garden but the owner later removes it, the contractor may have already designed structural reinforcements to support the garden. The removal may require design modifications, potentially leading to additional costs rather than just simple savings.
How Negative Variations Affect Project Costs
Negative variations may reduce project costs, but the financial impact isn’t always straightforward. While they lower immediate expenses, they can also create inefficiencies, disrupt cash flow, and lead to unexpected costs elsewhere in the project. Poorly managed variations may even increase expenses rather than save money.
1. Short-Term Savings vs. Long-Term Costs
Cutting work reduces upfront costs. A project owner might remove high-end finishes, scale back landscaping, or eliminate a secondary structure to stay within budget. These changes lower expenses immediately and can help keep the project financially on track.
But not all reductions lead to true savings. Removing critical features now could mean paying more to reinstate them later.
💡 Example: Skipping a backup generator in a hospital build might seem like a smart cost-cutting move. But if regulations or operational needs require one later, retrofitting the system could cost far more than if it had been installed from the start. Similarly, cutting a secondary access road in a new development might save money upfront. But if traffic congestion becomes an issue later, adding the road back could mean extra excavation, roadworks, and disruption—turning a simple cost-saving measure into a major expense.
2. Cash Flow Disruptions for Owners and Contractors
Negative variations change how money moves through a project.
- For project owners: A negative variation means spending less in the short term. This frees up funds for other priorities, but it can also lead to financial adjustments, contract renegotiations, and administrative delays.
- For contractors: Reduced work can disrupt cash flow, especially if they’ve already ordered materials or scheduled subcontractors.
💡Example: A contractor expecting to install 1,000 square meters of flooring may have already procured materials and scheduled labor. If a negative variation cuts this to 600 square meters, the contractor must either store unused materials (which costs money) or return them (which may include restocking fees). If subcontractors were engaged based on the larger scope, reducing work may lead to compensation claims or renegotiations.
3. Changes in Supplier and Subcontractor Pricing
Reducing scope doesn’t just affect the main contractor. It also impacts suppliers and subcontractors. Many pricing agreements include bulk discounts, so a smaller order could increase the per-unit cost of remaining work.
💡Example: If a developer initially orders 500 custom doors but later reduces it to 300, the supplier may remove bulk pricing discounts, increasing the per-unit cost. The expected savings may shrink or even disappear.
Subcontractors can also renegotiate rates if the job size changes. If an electrical subcontractor was hired for a full fit-out but the scope is cut in half, they may increase their pricing per unit to maintain profitability. Without clear contract terms, these adjustments can lead to disputes.
4. Unexpected Costs in Other Areas
Cutting costs in one part of a project can create additional expenses elsewhere. Removing certain work may seem like a simple cost-saving measure, but it can lead to inefficiencies or the need for rework later.
💡Example: Eliminating a planned stormwater drainage system during early budgeting might seem harmless. But if heavy rainfall causes flooding issues during construction, installing the system later could be far more expensive. Extra excavation, new permits, and design changes could add significant costs.
Another common issue is cutting back on insulation in a commercial building. While this reduces upfront expenses, it might lead to higher heating and cooling costs or even compliance failures, forcing costly retrofits.
How to Manage Negative Variation Effectively
Project owners and managers must take a structured approach to handle negative variations effectively. This will ensure fairness, proper documentation, and minimal disruption to workflows.
Here’s how to get it right:
1. Set Clear Contract Terms
Contracts should explain how negative variations are calculated. They should also state whether contractors get compensation for materials already ordered or work already done. Clear terms prevent disputes.
2. Assess Risks Before Cutting Work
Saving money now can lead to higher costs later. Removing key features might cause rework, compliance issues, or inefficiencies. Every change should be reviewed carefully.
3. Communicate Early with Contractors
Scope reductions affect labor, materials, and schedules. Contractors need time to adjust. Early discussions prevent last-minute problems.
4. Document Every Change
Every variation should be recorded with clear details on scope changes, cost adjustments, and any agreed compensation. Poor documentation leads to disputes and delays.
The Mastt's Variation Tool simplifies this process, allowing teams to track, approve, and visualize variations effortlessly. It automates paperwork and links changes to project budgets, reducing admin work and ensuring accuracy.
5. Resolve Disputes Fairly
Contracts should outline how disputes will be handled. Mediation, negotiation, or contract reviews can prevent minor disagreements from escalating.
Final Thoughts on Negative Variations
Negative variations are a normal part of construction projects. But they require careful handling. While reducing costs might seem like a win for project owners, unexpected consequences can quickly erase those savings.
For project owners, negative variations offer flexibility. But they must be assessed carefully to avoid cutting essential work that could lead to higher costs later. Contractors, on the other hand, need fair processes to adjust their scope and payments without disruption.
The key is balance: save where you can, but never at the cost of long-term success.
